March 25, 2026

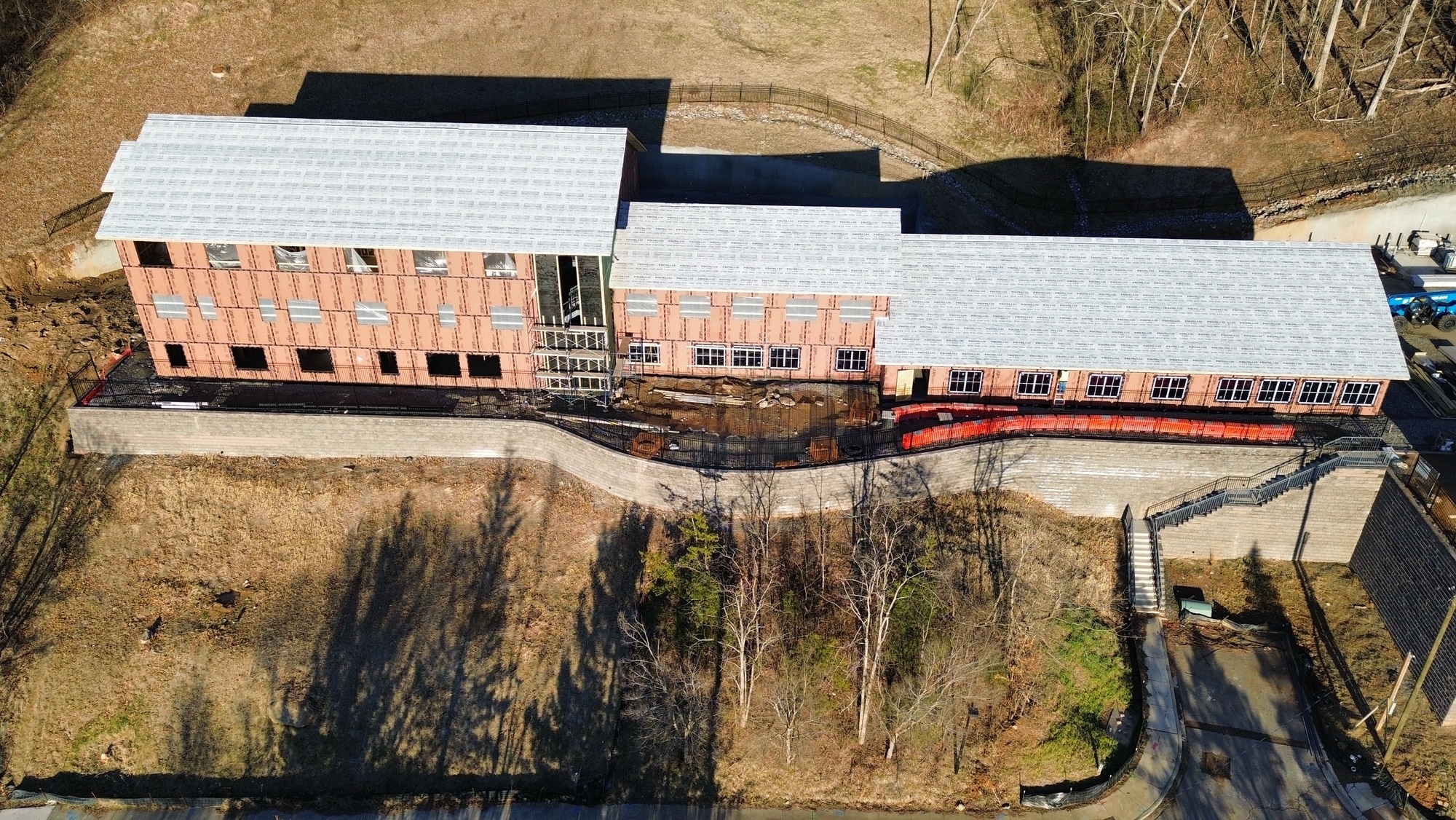

The team at Beverly-Grant continues to make remarkable progress on Joy’s House, bringing us closer to an operational building every day!

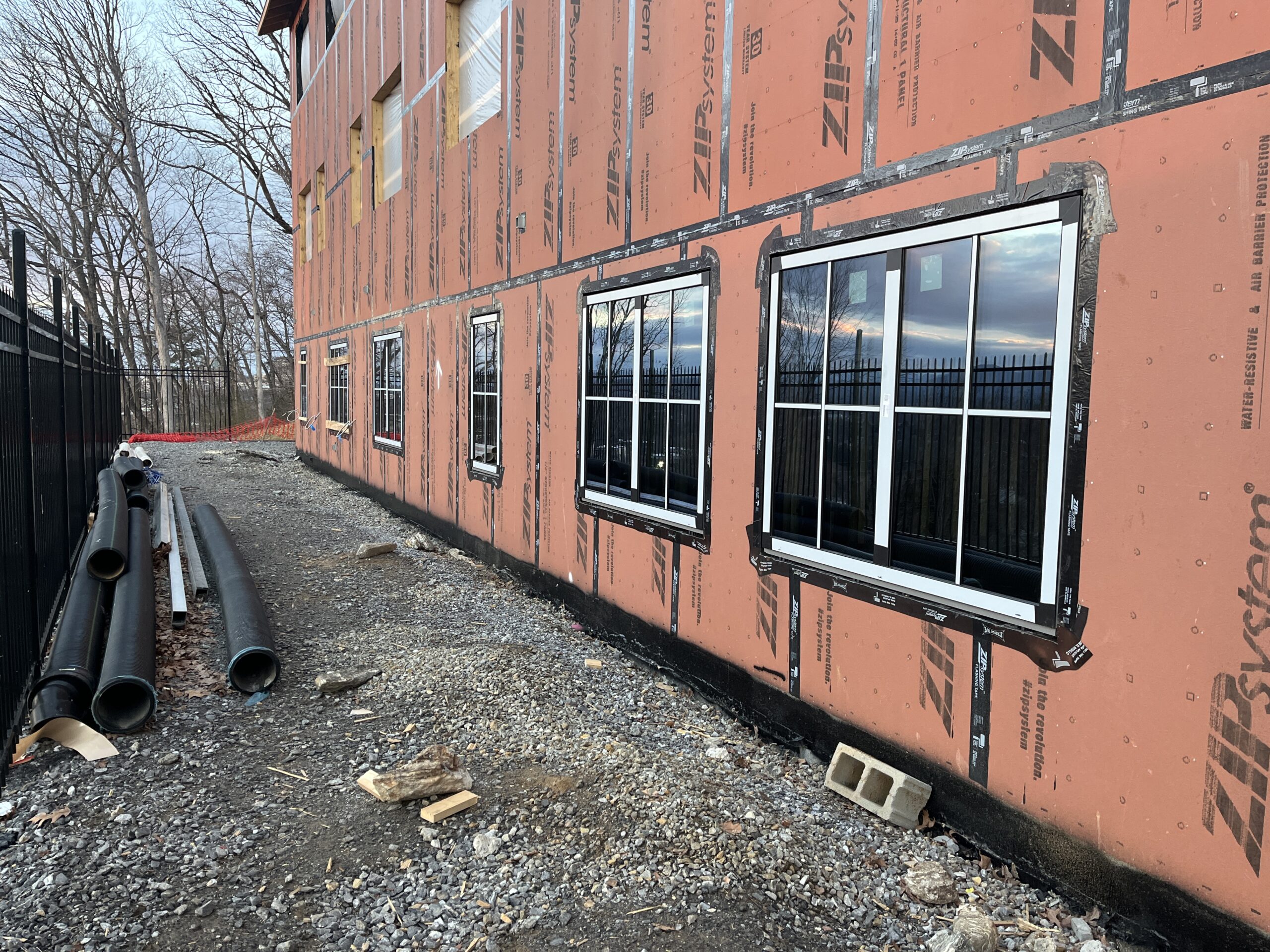

Drywall on the first level of the building is complete, and the team is currently working on insulating the HVAC ducts and second and third-level roof decks. The roof deck of the community block will follow, pending the arrival and installation of the exterior canopy. Siding work continues, with just a little left at the north end of the site. We are expecting a stone delivery on the 30th, which will allow us to start working on the stone at the South end of the first level.

Inside, natural gas work has begun, and Enbridge is scheduled to bring gas pipes to the building by mid-May. The sprinkler system is prepped for a hydro test, but we’ll wait for warmer weather to complete it. Meanwhile, air testing of the sprinkler lines is already finished.

March 5, 2026

Things are really taking shape on site! Siding work is well underway — about a third complete, including the fascia and soffit. Inside, the teams are busy with plumbing, HVAC, sprinkler, and electrical rough-ins, keeping everything on track.

Insulation is moving along nicely, with both spray foam and batt insulation in progress throughout the residential areas. We’re happy to share that we passed insulation inspections with both Southern Energy and the City.

Rated drywall on one side of the residential unit walls is already underway, and now that insulation is approved, we’ll start on the other side. The second-level attic ductwork and the sprinkler system all the way to the community block have also passed inspection. It’s exciting to see the building coming together piece by piece!

February 5, 2026

The team at Beverly-Grant continues to make steady progress, with several major building systems now in place and others moving toward completion.

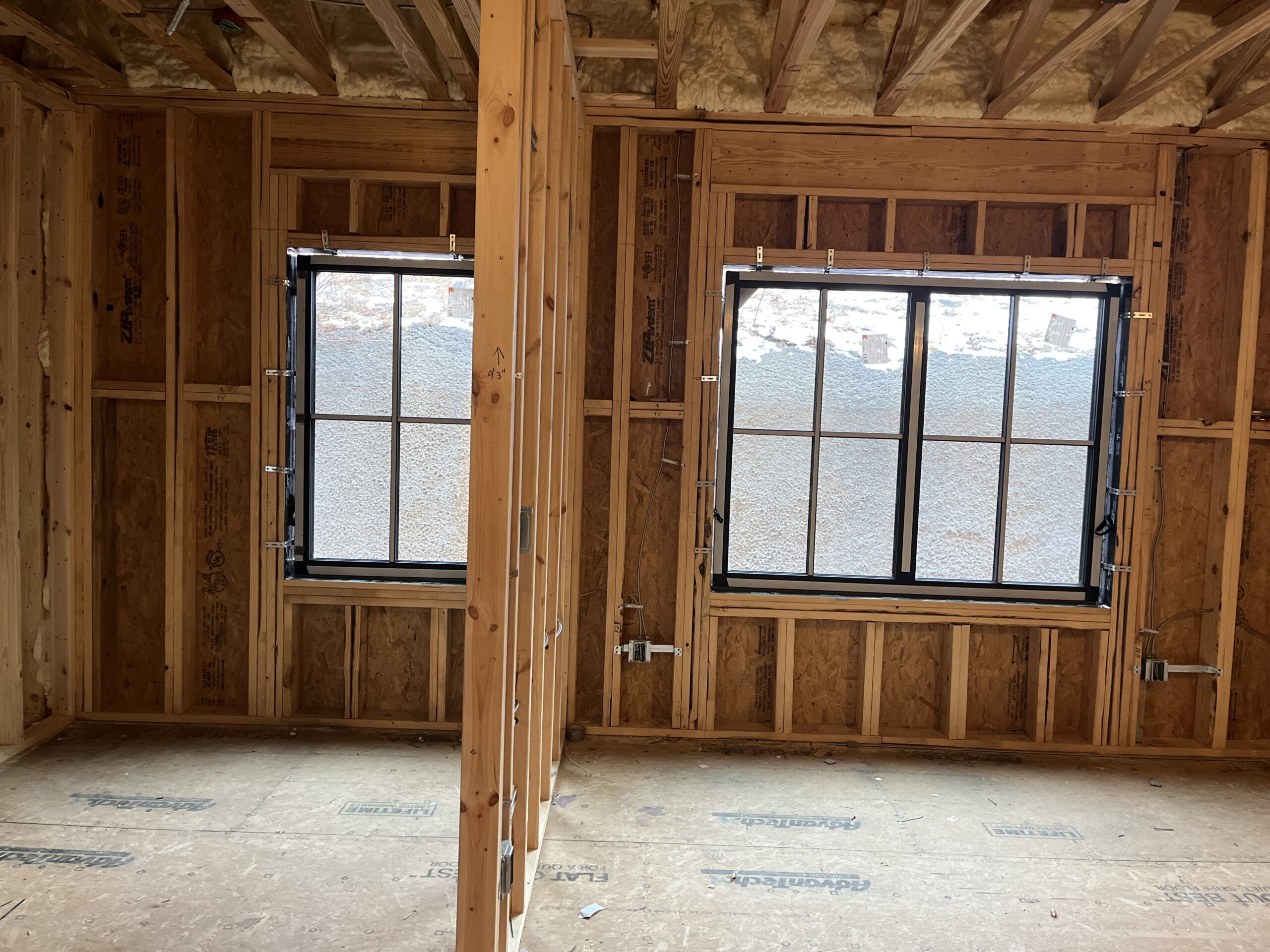

Work is underway to install insulation over the stair towers, which is an important step before the siding can be added. Windows are nearly finished throughout the building, and crews have begun sealing them to protect against weather. The remaining windows in the stairwells will be installed last, which is typical for this stage of construction.

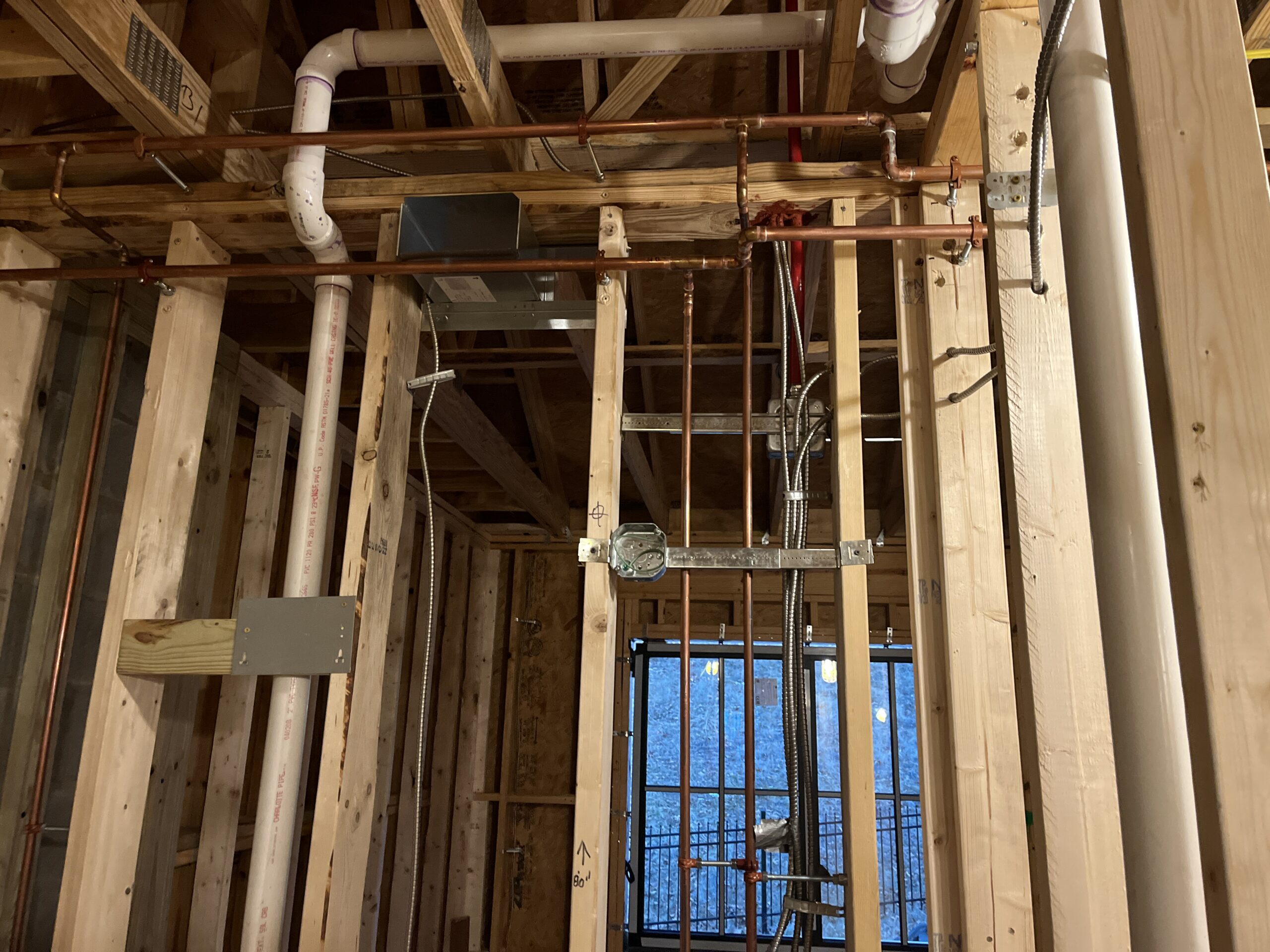

Inside the residential portion of the building, all plumbing waste piping has been installed, inspected, and approved. Installation of copper water lines is now in progress, which will supply water to the apartments. Heating and cooling work is also moving forward, with HVAC venting and ductwork currently being installed.

The central staircases are fully complete, providing permanent access throughout the building. On the exterior, installation of fascia and soffit (the finished edges and undersides of the roofline) is underway, giving the building a more complete appearance. Spray foam insulation has been installed along the building perimeter and throughout the first- and second-floor residential corridors, and this work has passed inspection.

December 12, 2025

The team at Beverly-Grant continues to make huge progress on the shelter. Inside, the plumbing is moving forward with the rough-in work, and the electricians are laying out where outlets, switches, and fixtures will go and drilling the pathways needed for wiring.

On the exterior, the crew is working on the roof structure. They’re installing the sub-fascia and adding the sheathing to the trusses, which helps tie the roof system together and prepares it for the next phases of construction. Once this work is complete, the team will begin building the interior stairways.

November 24, 2025

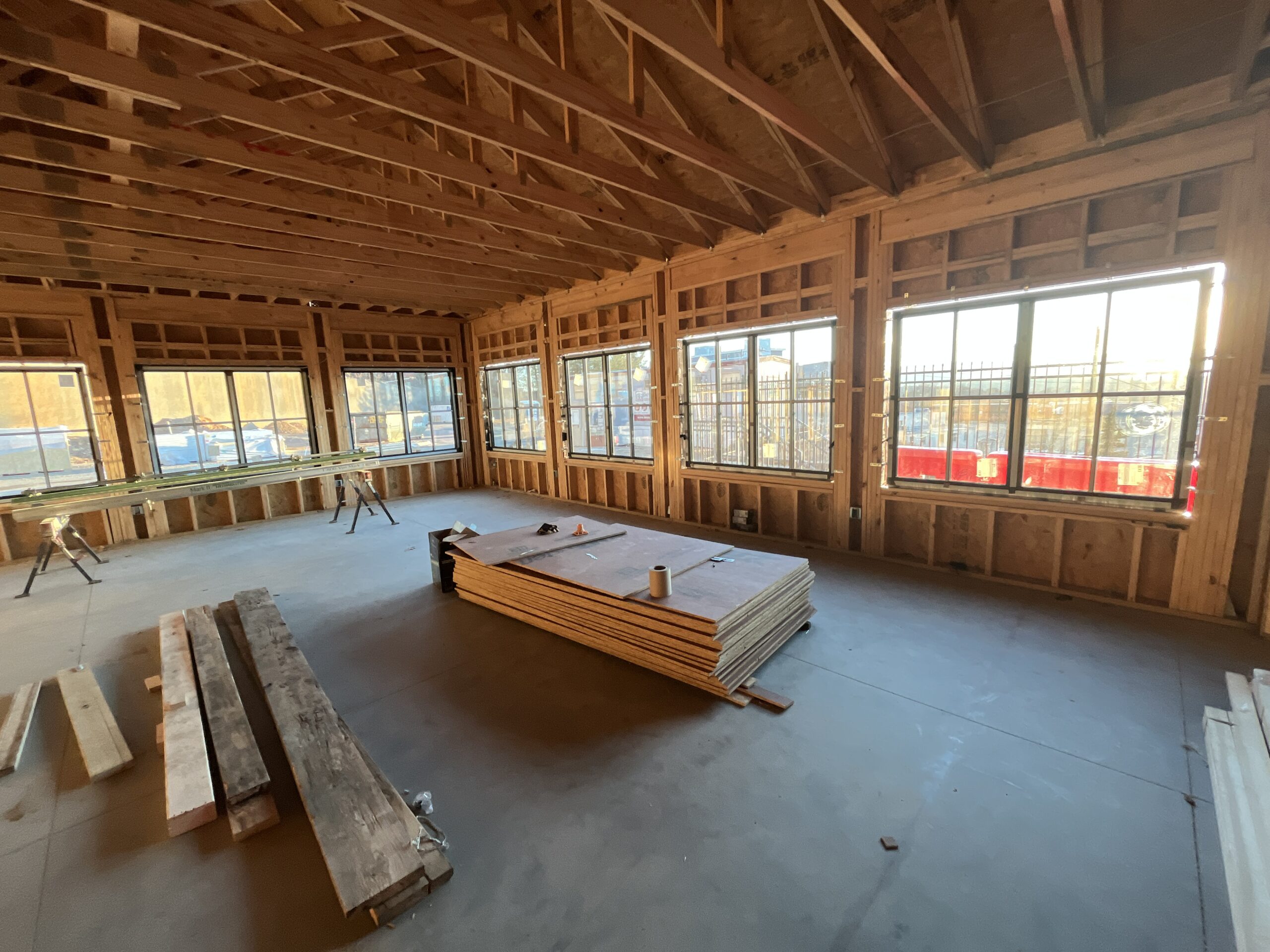

The team at Beverly-Grant has made a lot of exciting progress recently. The structural framing for the residential side of the building is now complete, and crews have begun putting up the interior walls that divide the individual units. Work on the exterior sheathing is also underway — this is an important step that helps protect the building from the elements as we move toward “drying in,” or sealing the structure from weather. Plumbing rough-in began on 11/12, and we expect windows to arrive within the next week to week and a half. Once they’re here, the team will wrap the openings and install the windows so the building can be fully closed in. Electrical rough-in is scheduled to start in the second week of December, depending on how quickly the building is dried in.

November 3, 2025

Exciting progress continues at the future site of Joy’s House! Recent work has focused on completing foundational preparations and beginning the structural framing of the building.

Crews have finished the underground plumbing and electrical work and installed the natural gas line that will connect to the building’s generator. After carefully marking the foundation and setting the base supports, framing began in earnest.

The residential portion of the building is now coming to life—framing and flooring for both the first and second levels are complete. The office area has also reached the same milestone, with its framing, floor trusses, and sheathing finished.

Each step brings us closer to opening the doors of Joy’s House, a safe, welcoming space that will double our shelter capacity and provide comfort and dignity to survivors of domestic violence in our community.

Stay tuned for more updates as construction continues!

October 1, 2025

Progress on our new shelter is moving steadily forward! In September, the elevator shaft was finished, and the plumbing and electrical work that goes beneath the foundation was wrapped up. The underground connections for the electrical transformer and generator were also completed, with the team waiting on final equipment specifications. By the end of September, the concrete foundation was poured, creating a solid base for the building. The site is now prepared for the electrical transformer to be delivered, and the most exciting step yet is just around the corner: the walls will begin rising next week, and the shelter will truly start to take shape.

August 12, 2025

Construction on our new shelter is moving along steadily, and exciting progress is being made. The base layer of the parking lot is now complete, offering the first sense of how the site will come together. Exterior stairs have been finished along the retaining wall, and crews are installing the underground electrical and communication lines that will power the building. A safety fence is being added at the top of the retaining wall, while drainage systems around the foundation are now in place to protect the shelter from heavy rains. Insulation has been installed around the building’s base to boost energy efficiency, and the elevator area, stair towers, and lower walls have been filled and reinforced. Work is progressing on the north stair tower, and the fully powered job trailer on site is serving as the hub for our construction team.

June 5, 2025

Construction is coming along on the build site for Joy’s House.  The team at Beverly Grant Construction recently put permanent fencing above the soil nail walls, meaning 85% of the fencing for the entire shelter is complete. They are now working on the segmental wall for the front of the shelter building, but that process has been slowed by rain.  The team has made substantial progress on installing the water lines and anticipates having them complete in the near future. Grass has been sown on the site to prevent erosion.  The construction team is about to start digging out the building pad and under-slab conduits and are currently obtaining estimates for the solar panels. The site work should be largely completed and the building construction underway by late July/early August. The Shelter Interiors Committee has selected flooring colors and types and are in conversation about the ideal layout for the kitchen.

Unfortunately, due to the heavy rains and the discovery of more rock, construction is now scheduled to wrap up in mid-June 2026.

May 1, 2025 Update

The construction team at Beverly Grant is hard at work on the new shelter.   Within the next week they anticipate finishing the soil nail walls and pouring more concrete into the deep foundation. This is a big milestone in the project and means we are getting closer to vertical construction, which is projected for late July.  Already, a driveway has been cut in, stormwater retention systems have begun to be installed, sewer lines have been laid and the parking area retaining walls have been built. The construction team recently increased the size of the water lines to ensure adequate flow for the new sprinkler system. Construction is predicted to be finished by June 2026.
