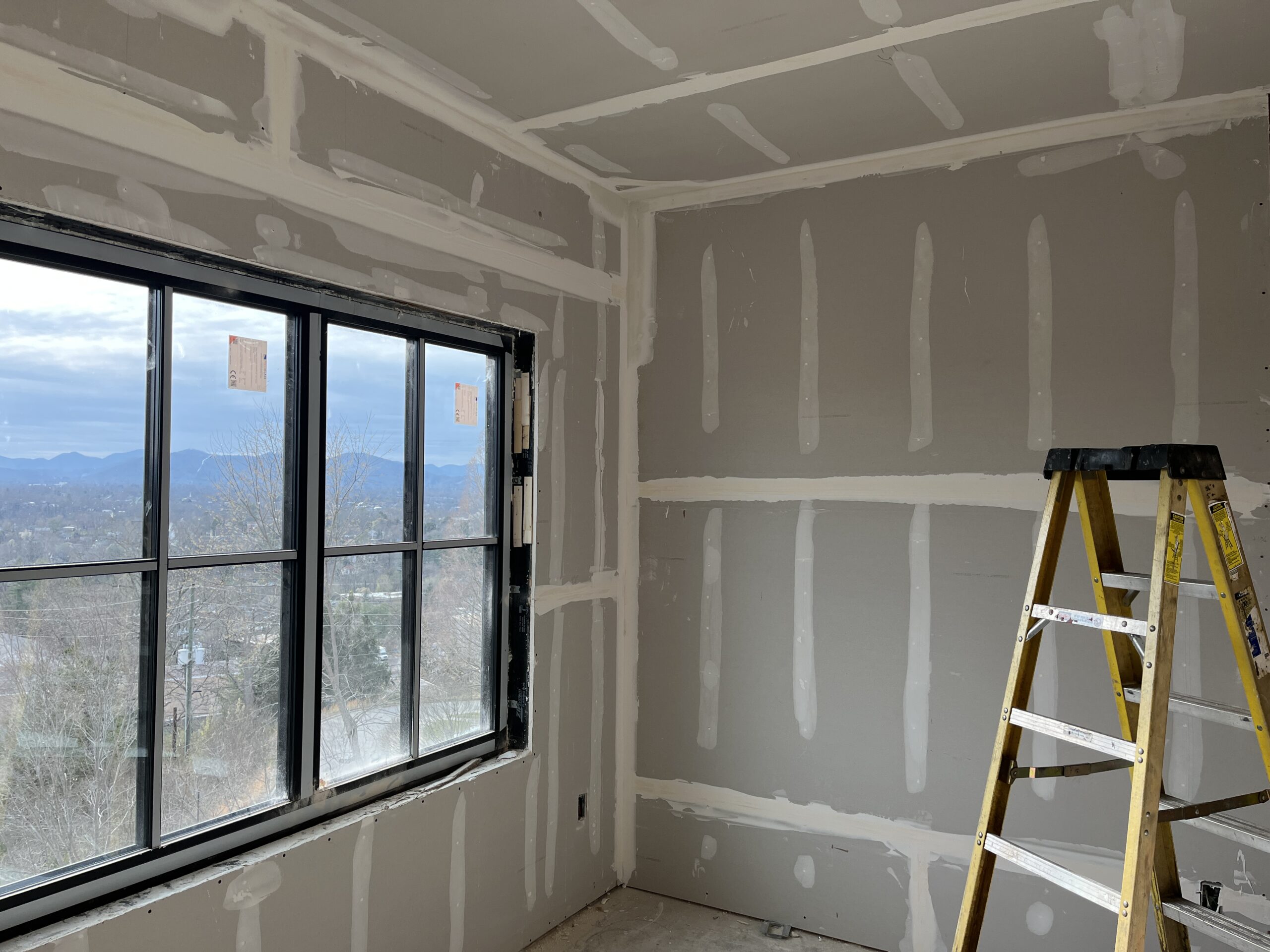

The team at Beverly-Grant continues to make remarkable progress on Joy’s House, bringing us closer to an operational building every day!

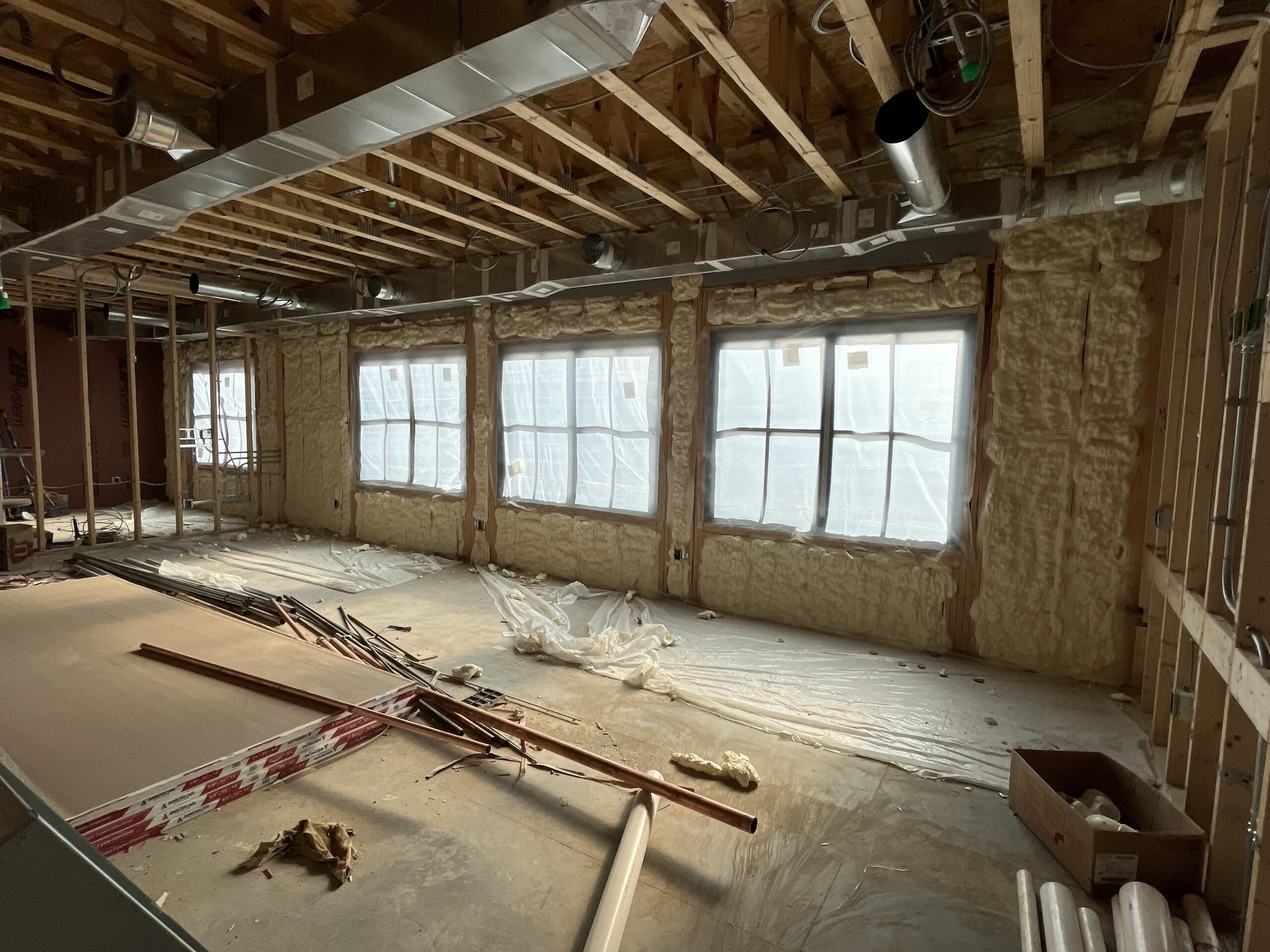

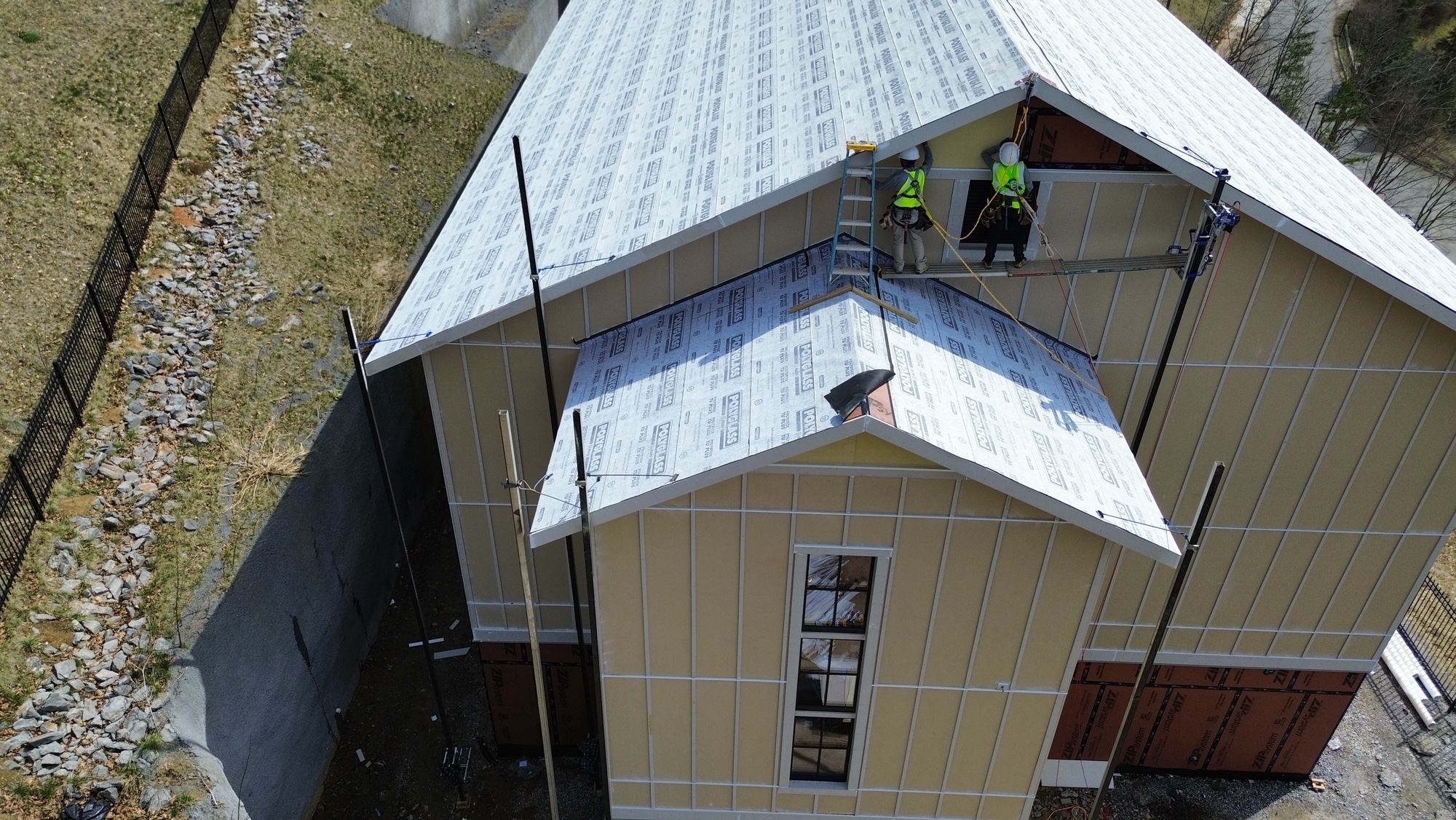

Drywall on the first level of the building is complete, and the team is currently working on insulating the HVAC ducts and second and third-level roof decks. The roof deck of the community block will follow, pending the arrival and installation of the exterior canopy. Siding work continues, with just a little left at the north end of the site. We are expecting a stone delivery on the 30th, which will allow us to start working on the stone at the South end of the first level.

Inside, natural gas work has begun, and Enbridge is scheduled to bring gas pipes to the building by mid-May. The sprinkler system is prepped for a hydro test, but we’ll wait for warmer weather to complete it. Meanwhile, air testing of the sprinkler lines is already finished.
